Wellington College V&A Café, Crowthorne
Delivering a high-end café fit-out to a tight recovery programme
Project overview
The V&A Café sits at the heart of Wellington College and was refurbished to create a contemporary all-day food and social destination for pupils and staff. The revamped café reopened in November 2023 and now operates as a high-capacity, flexible dining and social space within the College campus.
CJ Joinery worked as an installation specialist within the wider refurbishment, handling a varied package of bespoke joinery and high-end finishes while the overall programme was under pressure following delays caused by poor subfloor conditions discovered during strip-out.
Key figures
- £60k
- CJ Joinery package
- £2.5m
- Wider project value
- 50m² approx.
- Acoustic timber wall panels
- 30m approx.
- Coffee / energy bar and front counter
- 120m approx.
- Skirting
- Install only
- CJ package
- Weekend & overtime working
- Used to recover programme
- 2023
- V&A Café reopened
Scope of works
CJ Joinery delivered an install-only package valued at £60k. Key works included:
- Installation of heritage-style faux brick wall panels
- Installation of approximately 50m² of acoustic timber wall panelling
- Installation of the coffee / energy bar and front counter, approximately 30 linear metres
- Installation of Corian worktops and other high-end finished surfaces
- Installation of faux planters including associated metalwork
- Installation of salad / deli bar joinery
- Installation of hot food bar joinery
- Installation of soup and hydration station
- Approximately 120m of skirting
- Doorsets and associated ironmongery
- Fireplace surround and integrated log store
- Formation of openings associated with M&E extraction works
The challenge
The main challenge was programme pressure. Delays elsewhere in the refurbishment followed the discovery of poor subfloor conditions during strip-out, reducing the time available for the joinery installation package.
CJ was then working with detailed bespoke items and premium finishes, including Corian worktops and decorative brick-effect wall panels, where rushing the installation could easily have compromised the final appearance.
Our approach
CJ worked closely with Cardinal Project Management and the wider site team to recover lost time without lowering the standard of finish. The team increased its working hours and used weekends, overtime and longer days to keep the joinery package moving.
Particular strengths included:
- Extended working hours to recover programme delays
- Weekend working when required to maintain progress
- Careful handling and installation of high-end materials
- Close setting-out control to bespoke counters and fitted joinery
- Regular coordination with the project manager and other trades
- Maintaining finish quality despite the compressed programme
Outcome
CJ Joinery completed its installation works to the required programme despite the earlier delays affecting the wider refurbishment.
The standout result was the quality of finish achieved across the bespoke joinery and premium materials. Corian worktops, specialist counters, faux brick wall panels and decorative fitted elements were installed to a high standard while the team simultaneously worked extended hours to recover time.
The project demonstrates CJ Joinery Contracts' ability to deliver high-end commercial joinery package work where presentation, detail and programme recovery are all critical.
Frequently asked questions

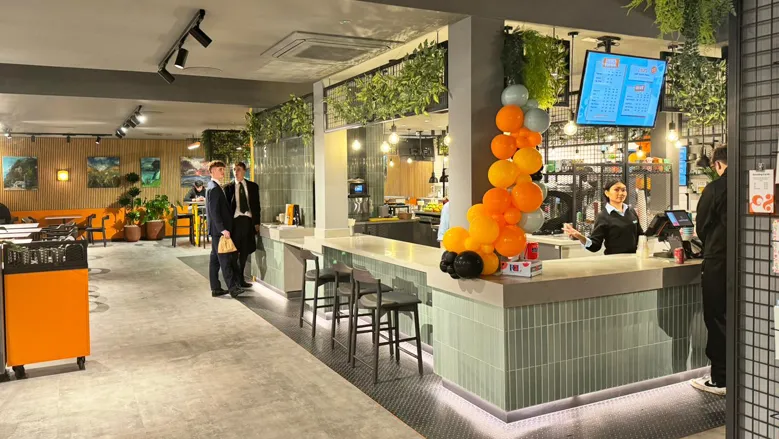

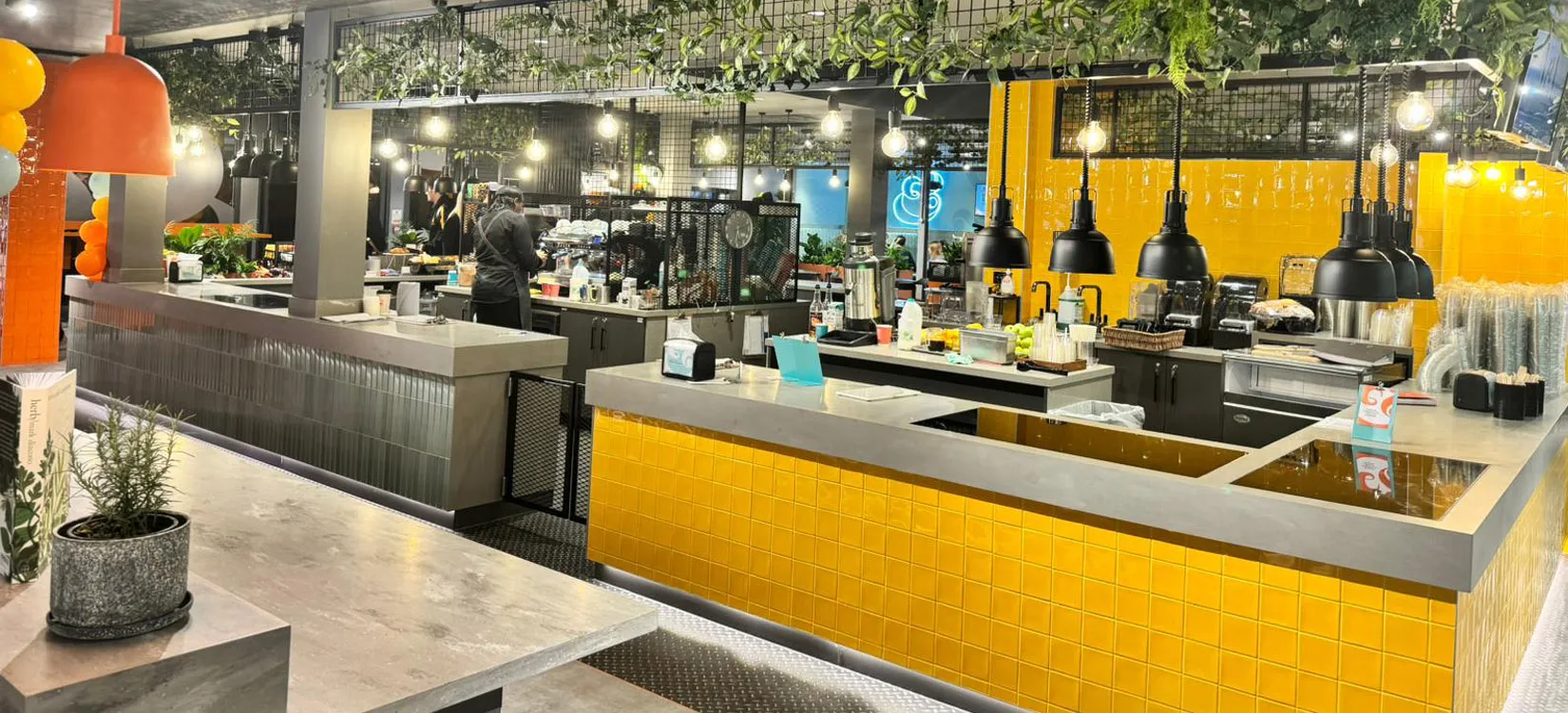

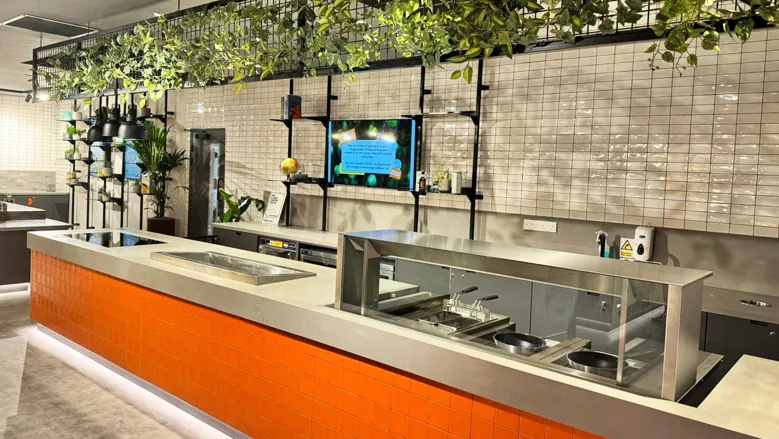

On-site imagery
More projects like this
Travelodge Extension, Boston
Installing the complete joinery package and a complex trussed roof on a hotel extension.
Read case studyRetailBoyleSports Nationwide Retail Rollout
Nationwide retail joinery rollout across 28+ high-street locations.
Read case studyAutomotiveJaguar Land Rover Design and Engineering Centre
Labour-only Cat B joinery installation for the £200m JLR Design & Engineering Centre.
Read case study
